¿Cómo gestionar las limitaciones de capacidad y los retrasos de los proveedores al obtener Polvo Mágico de Fuego antes de la temporada alta?

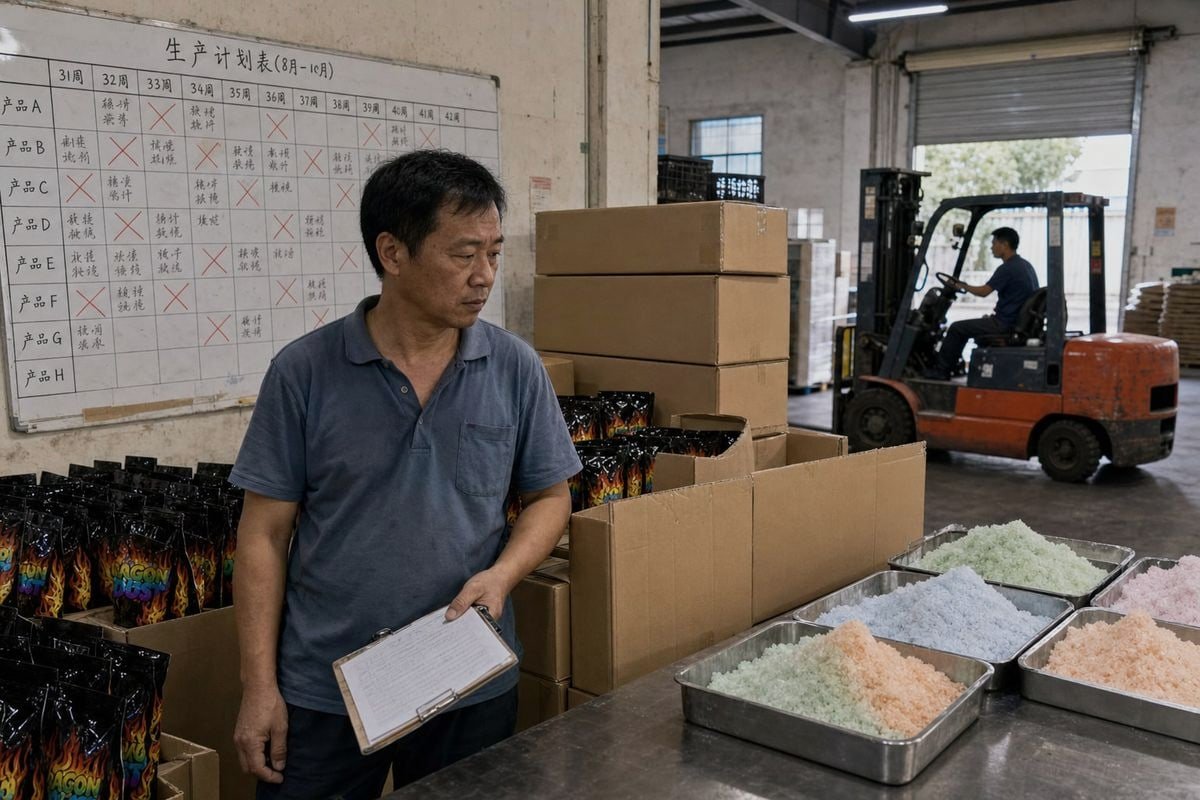

Guide to managing Magic Fire powder supplier delays and capacity constraints before peak season (ID#1)

Supplier capacity constraints hit Magic Fire powder buyers hardest right before peak season. Every autumn, our Ningbo production line fields urgent calls from importers whose orders arrived too late.

Handle supplier capacity constraints for Magic Fire powder by booking production 12–16 weeks before peak season, reserving capacity with contracts, verifying factory output through audits, holding 4–8 weeks of buffer stock, and pre-qualifying a compliant backup supplier before shortages appear.

That is the short answer. The longer answer explains why delays happen, how to verify real capacity, and how to build a backup plan that protects both compliance and quality. Let's go through each part.

What causes most Magic Fire powder supplier delays before peak season?

Last October, a German distributor asked us to rescue an order after their previous vendor missed a six-week window. That failure started months earlier, not at the port. Here is why.

Most Magic Fire powder delays come from four causes: buyers placing purchase orders too late, factories overselling limited seasonal capacity, single-sourced supply chains with no fallback, and freight forwarding delays during congested Q4 shipping windows. The root problem is a missed capacity window, not slow production.

Four main causes of Magic Fire powder supplier delays before peak season shipping (ID#2)

Color-flame powder is a strongly seasonal product. Demand for campfire, fireplace, and fire-pit items compresses into a narrow ordering window from late summer through early winter. When hundreds of brands order in the same eight weeks, even a small slip becomes a stockout on the shelf.

Capacity problems vs. lead time problems vs. inventory problems

Many buyers lump all delays together. In practice, they are three different problems with three different fixes. In our 17 years of exporting fire products to more than 30 countries, we have seen buyers "solve" the wrong one repeatedly.

Problem type Cómo se ve The real fix
Capacity constraint Factory accepts the PO but ships short or late Reserve production slots earlier; split volume across vendors
Lead time problem Production is fine, but total cycle is 10–14 weeks Order earlier; optimize freight booking; pull orders forward
Inventory problem Demand spikes beyond forecast mid-season Stock de seguridad 1 management; buffer inventory for core SKUs

A capacity constraint is a time-phased limit. A factory can produce a fixed quantity per week. If your order lands after that week's capacity is sold, no amount of pressure creates more output. Unused capacity in July cannot help you in November unless your PO consumed it back in July. That is why "asking the supplier to rush" rarely works once the season is underway.

Production scheduling constraints get worse when a factory also serves other seasonal categories. Add customs documentation gaps, hazmat-adjacent labeling reviews, and carrier shortages, and a two-week production slip becomes a two-month commercial disaster. The lesson we share with every new buyer: delays are usually a capacity-allocation problem decided months before shipment, not a shipping problem decided at the port.

Most peak-season delays trace back to a purchase order placed after the supplier's capacity window closed Verdadero
Supplier capacity is a time-phased limit; once weekly slots are sold to earlier orders, later POs get pushed into future buckets, which lands them past the season.
A reliable factory can always speed up production if the buyer pays a rush fee Falso
Rush fees cannot create physical capacity that is already allocated; blending lines, drying time, and QC batch checks have fixed throughput that overtime only partially stretches.

How can I verify a supplier's true production capacity before placing my order?

A US camping brand once toured our Ningbo facility and counted filling machines 2 before signing anything. Smart move. Many "factories" quoting Magic Fire powder are actually trading companies reselling someone else's capacity.

Verify true production capacity by requesting a factory audit or live video tour, checking business licenses and export records, reviewing certifications like ISO 9001 and BSCI, asking for weekly output data by SKU, and testing responsiveness with a trial order before committing peak volume.

Steps to verify a supplier's true production capacity through audits and certifications (ID#3)

Verification is where good procurement teams separate themselves. A supplier's claimed capacity means little. What matters is capacity available to you, in the weeks you need it, at the quality level your market requires.

Una secuencia de verificación práctica

  1. Confirm they are a real factory. Ask for the business license, factory address, and production photos with your inquiry details visible. We are headquartered in Liuyang, Hunan — China's fireworks cluster — with production in Ningbo, and we expect buyers to check both.
  2. Audit or video-tour the line. Count blending, filling, and sealing stations. Ask for cycle rates. An hour on video reveals more than fifty emails.
  3. Verifique las certificaciones con informes de prueba. ISO 9001 and BSCI audits verify management systems and social compliance. informes de prueba SGS o Intertek 3 verify the actual powder. Ask for report numbers you can validate directly with the lab.
  4. Request time-phased capacity data. A serious supplier can tell you weekly output per SKU and how much is already committed for September through November.
  5. Place a trial order. Flexible MOQs for first orders exist precisely so you can compare the sample batch against the production batch. If batch-to-batch quality drifts, walk away before peak season.

Red flags that predict capacity failure

Señal Por qué importa
Vague answers on weekly output Suggests a trading company, not a producer
No third-party test reports Compliance risk at customs and retail
Sample quality differs from production batch Weak process control under pressure
Slow PO acknowledgment in the off-season Will be worse when demand spikes

Fuerte promedio plano 4 on your side help too. Sharing your forecast with the factory lets both parties plan honestly, and honest capacity conversations are the best early-warning system you can buy.

A trial order is the most reliable test of whether sample quality reflects mass-production quality Verdadero
Small first orders expose real batch-to-batch consistency, documentation discipline, and communication speed under actual production conditions, not showroom conditions.
A supplier holding a certificate copy proves it manufactures the product itself Falso
Trading companies frequently present borrowed or outdated certificates; only report numbers verified directly with the issuing lab, plus a factory audit, confirm genuine manufacturing depth.

What lead times should I expect and how far ahead should I book peak season production?

Every June, our production planner blocks out the autumn calendar, and every August someone calls hoping November slots still exist. They usually do not. Timing is the single biggest lever buyers control.

Expect 30–45 days of production plus 30–40 days of ocean freight for Magic Fire powder, so book peak season production 12–16 weeks ahead. For Q4 retail programs, confirm purchase orders by late June or July to secure capacity and avoid freight congestion.

Expected lead times and booking timeline for Magic Fire powder peak season production (ID#4)

Lead time optimization starts with mapping the full cycle, not just factory days. Buyers often plan around production time and forget everything wrapped around it.

The real end-to-end timeline

Etapa Duración típica Notas
Sampling and private-label artwork approval 1–3 semanas Longer for custom boxes and display packaging
Raw material procurement 1–2 semanas Mineral salt colorants can tighten in peak months
Producción y control de calidad por lotes 4–6 semanas Depends on order size and slot availability
Compliance docs, labels, barcodes Parallel, 1–2 weeks Pre-clear warning labels to avoid customs holds
Flete marítimo a EE. UU./UE 4–6 semanas Freight forwarding delays spike in Q4
Inland delivery and receiving 1–2 semanas Add buffer for warehouse cutoffs

Add it up and a first-time custom order can run 14–18 weeks door to door. Repeat orders with approved artwork run faster, but the freight window does not care how experienced you are. Carrier space around Semana Dorada 5 and pre-Christmas peaks disappears early, so we advise buyers to secure logistics capacity months in advance, not weeks.

Reserving capacity, not just placing orders

One trend we encourage: capacity reservations. Some of our long-term distributors pay for or contractually commit to production slots during the low season. In exchange, they get guaranteed weekly output in September and October, plus defined escalation terms if anything slips. This mirrors what sophisticated planning teams do — treat capacity as a scarce, time-bound resource. Unused capacity today only protects your season if your commitment consumes it early. A rolling forecast shared quarterly, even a rough one, lets us hold material and line time against your name. That single habit prevents more stockouts than any expedite fee ever will, and it strengthens supply chain resilience for both sides.

How do I build a backup sourcing plan without sacrificing compliance or quality?

A UK buyer once told me their backup plan was "search Alibaba in a crisis." That is not a plan. Procurement contingency planning must be finished before the shortage starts, not during it.

Build a backup plan by pre-qualifying a second compliant supplier in the off-season, cross-approving artwork and test reports with both vendors, splitting trial volume 80/20, holding 4–8 weeks of buffer stock for core SKUs, and defining clear allocation rules for shortages.

Building a compliant backup sourcing plan with dual suppliers and buffer stock (ID#5)

A backup source that fails compliance is worse than no backup at all. Color-flame products face retail chemical scrutiny 6, labeling requirements, and customs checks. If your emergency supplier ships powder without valid informes SGS o Intertek 7, you trade a stockout for a recall. So build the fallback with the same standards as the primary.

The four-layer backup framework

  1. Vendor diversification, done early. Qualify a secondary supplier during the off-season when factories have time for audits and trial runs. A multi-sourcing strategy works only if the backup is already approved, with artwork, barcodes, and warning labels on file, before demand spikes.
  2. Keep the backup warm. Route 10–20% of regular volume to the secondary vendor. A supplier who has not produced your SKU in a year is not a real backup. Small recurring orders keep tooling, packaging films, and QC criteria current.
  3. Inventory as a deliberate hedge. An inventory buffer strategy is not wasted cash; it is purchased flexibility. Segment your range: build 4–8 weeks of safety stock for your highest-velocity and highest-margin SKUs, and accept leaner cover on slow movers. Some buyers also pre-position stock in regional warehouses near major markets to cut final-mile time.
  4. Pre-agreed allocation rules. When a shortage still happens, quantify the gap, map which customers feel it, and allocate remaining supply to protect priority retail programs first. Deciding this in a calm week beats deciding it in a panicked one.

We support this openly. When a buyer tells us we are their primary source and asks for documentation their secondary vendor can be measured against, we see a professional partner, not a threat. Long-term supply relationships survive on transparency, consistent batch quality, and honest capacity conversations — not on locking buyers into a single point of failure.

A backup supplier must be qualified and producing small volumes before peak season to be useful Verdadero
Qualification, compliance testing, and artwork approval take weeks; a cold, unapproved vendor cannot ship compliant product fast enough to rescue an in-season shortage.
Holding buffer inventory for a seasonal product is just tied-up capital with no strategic value Falso
For constrained seasonal inputs, targeted safety stock on core SKUs is a deliberate flexibility tool that absorbs supplier slips and protects revenue during the exact weeks demand peaks.

Conclusión

Peak-season stockouts are painful, avoidable, and usually self-inflicted. Book capacity 12–16 weeks early, verify factories properly, hold targeted buffers, and pre-qualify a compliant backup. Plan the season before the season plans you.
